Project Prediction report - change time of project prediction for the last 3 months

Hello,

Is it possible to change the time of project prediction ?

In the Project Prediction report, the project predicted date take into account all issues since the start of the project, I want to have the velocity just for the last 3 months.

I added a new calculated member in the Time dimension for the period to track the performance for the prediction. (“Last 3 months”):
I tried to change the project predicted date to take into account just the last 3 months but it’s not working:

Cache(
Case when
([Measures].[Issues resolved],
[Time].[Last 13 weeks]) > 0
AND
([Measures].[Issues due],
[Time].CurrentHierarchy.DefaultMember) > 0
Then
DateAddDays( Now(),
– add days to reach this ammount
Cache(
– all currently open stroy points
([Measures].[Issues due],
[Time].CurrentHierarchy.DefaultMember)
/
– divided by days performance
Cache(
– resolved story points in last 13 weeks
([Measures].[Issues resolved],
[Time].[Last 13 weeks])
/
– days in the last 13 weeks
DateDiffDays(
‘13 weeks ago’,
‘today’)
)
)
)
End)

Thank you

Hi @Megacreation
Thanks for raising this question!
Your formula seems to be correct. You mentioned that you had created a new Time member and I see that you are also using it in the formula.

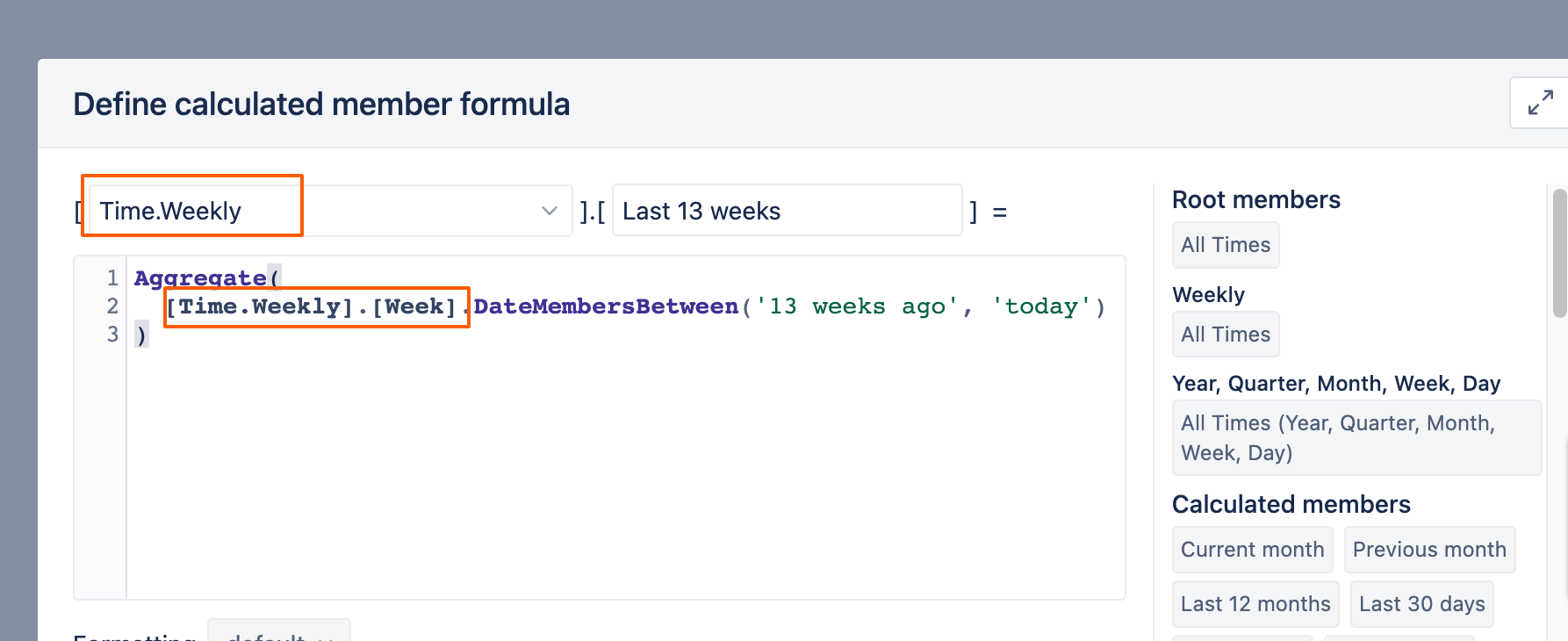

Can you please share a screenshot of how you have created your “Last 13 weeks” Time members?
Since that is a weekly member, please verify if you have created your member at the Weekly hierarchy.

If this doesnt fix the results in your report, please reach out to us at support@eazybi.com and send us your report definition (Export and import report definitions). Please also add a reference to this community post.

Best wishes,

Elita from support@eazybi.com
