We have the following hierarchy
For A Project we have EPICs that map to Features and EPICs contain 1… many stories
At a specific stage , An initial baseline estimate is updated in the EPICs in Story Points
When the stories are implemented , SP suzing is updated for each story
I want to create a cumulative report which can show me

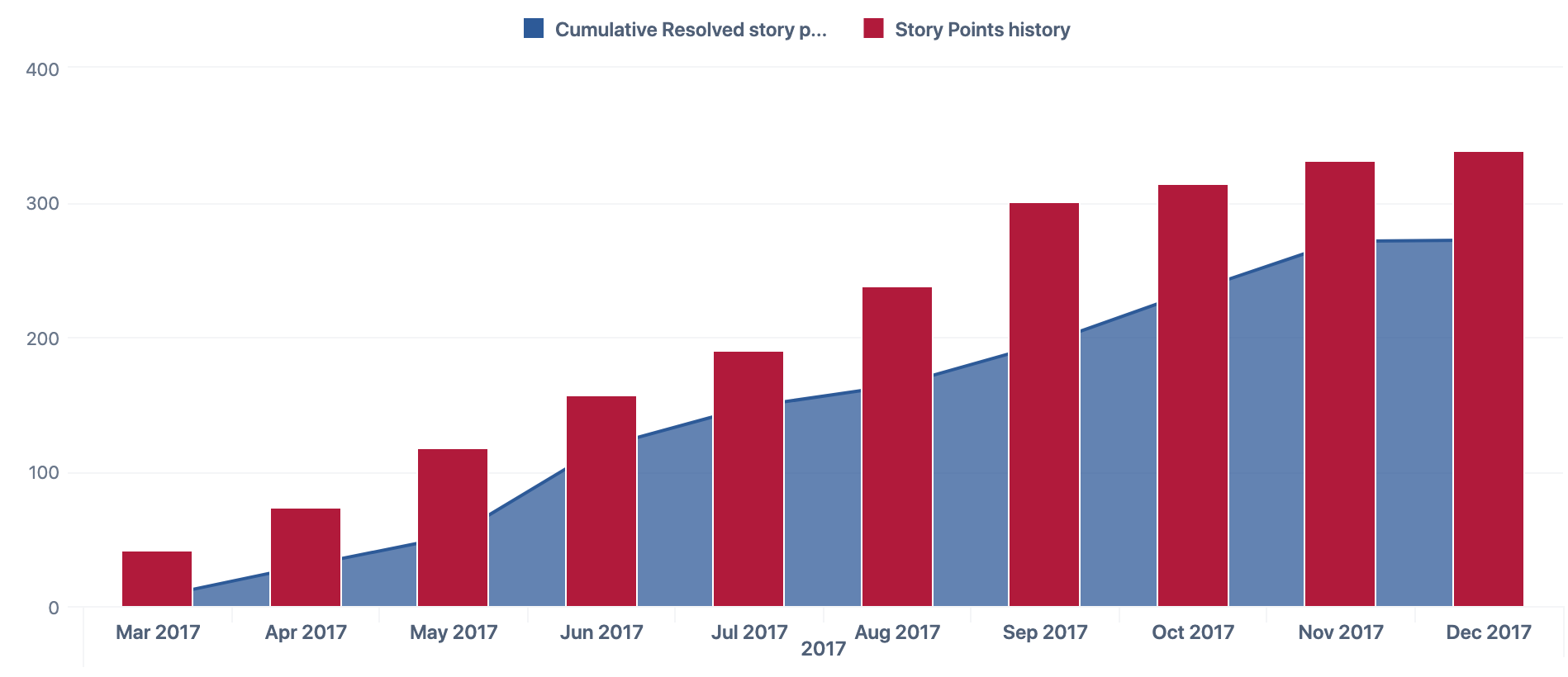

Cumulative Baseline estimates of all EPICS in Story Point over time AND
Cumulative completed story points by adding up Story points of all the completed stories over time

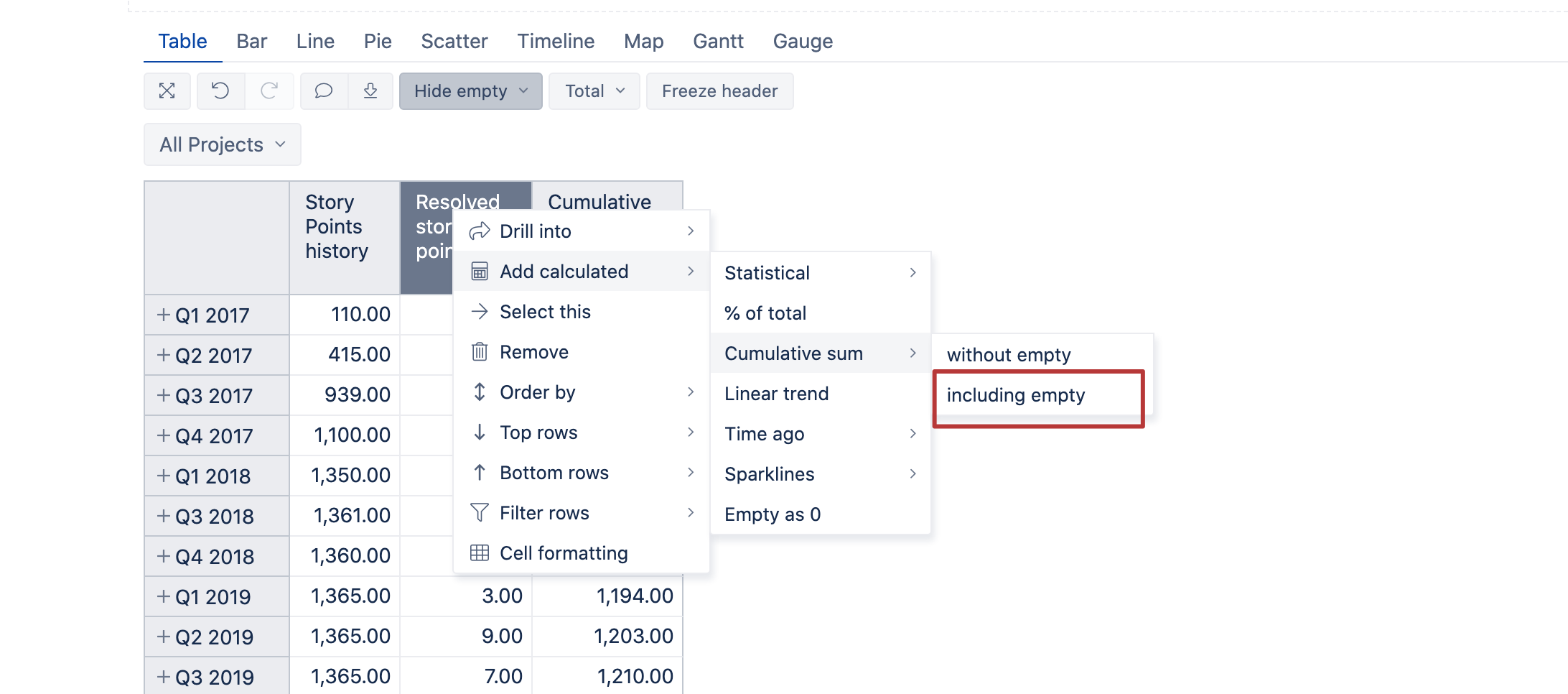

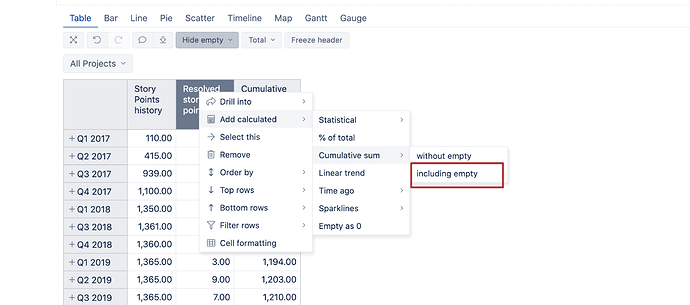

If you wish to track all the changes in the initial baseline, you can use the Story points history measure and get cumulative over time. However, as those story points are recorded for epics, you need to limit the story points measure by the issue type using a tuple. The following formula would do that:
